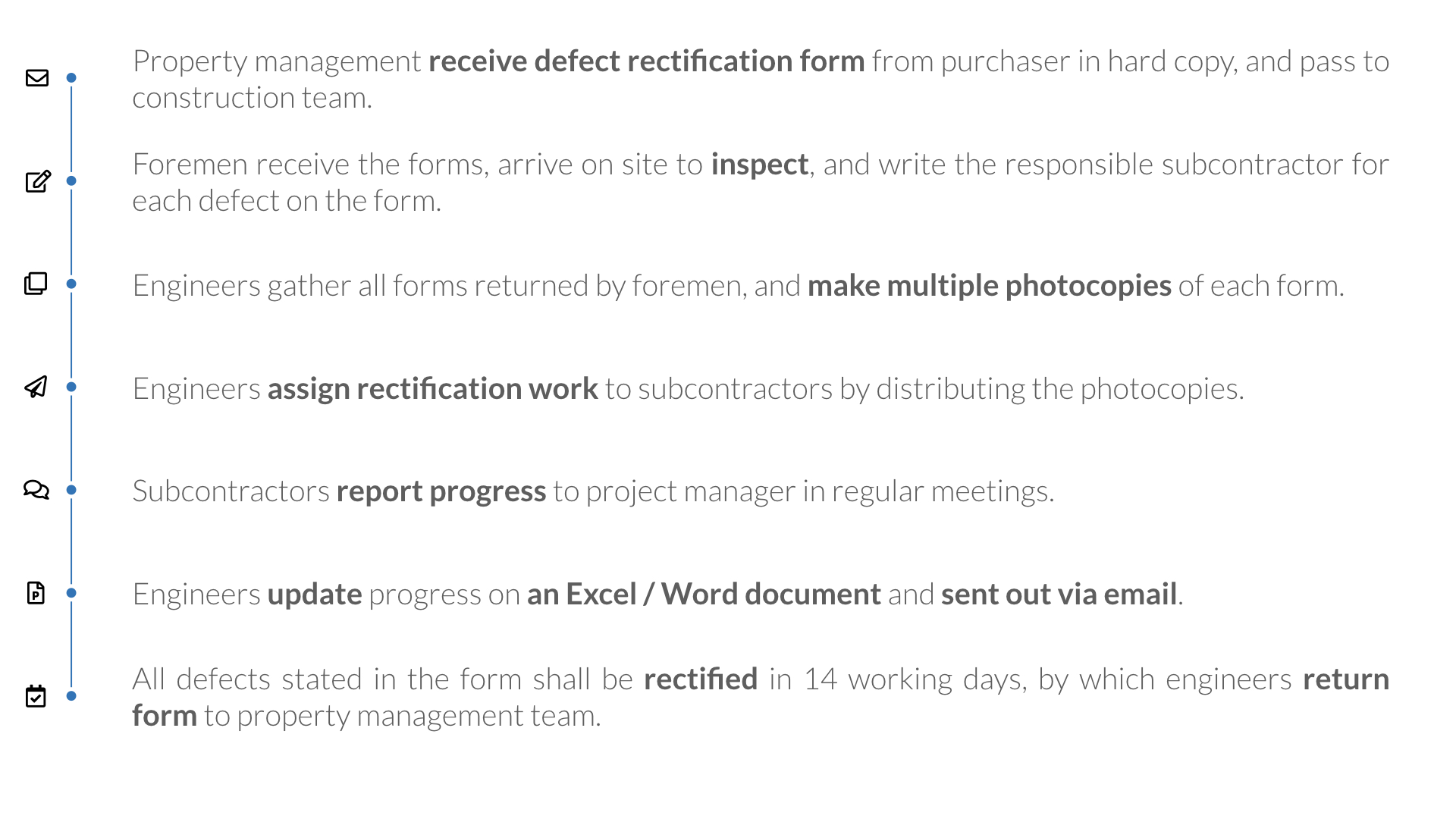

- Heavy reporting and administrative work for engineers
- Limited visualisations and accessibility to handover progress

- Easy to miss out defect items as information is decentralised

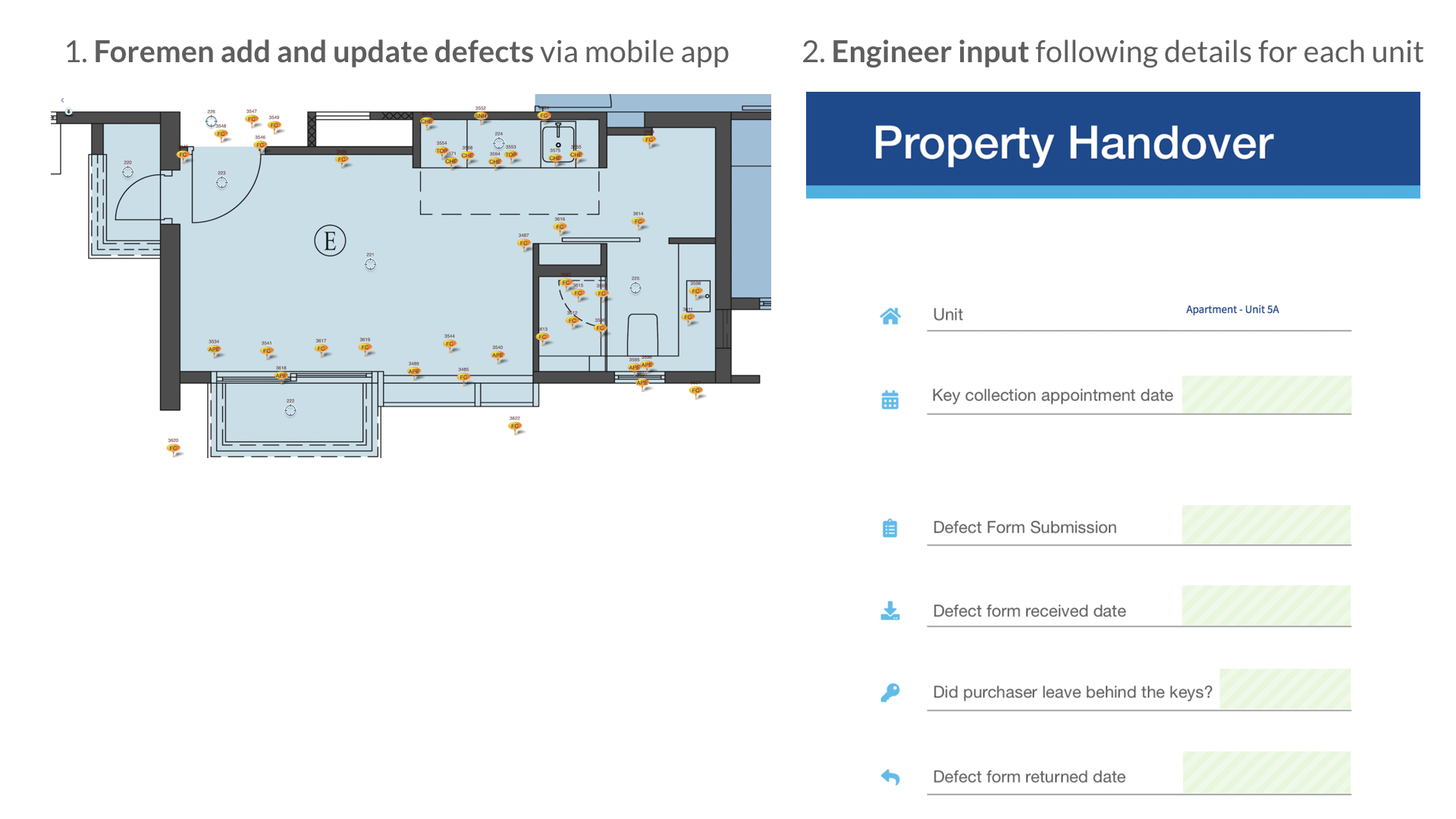

- Digitalise inspection process and reduce subsequent administrative work

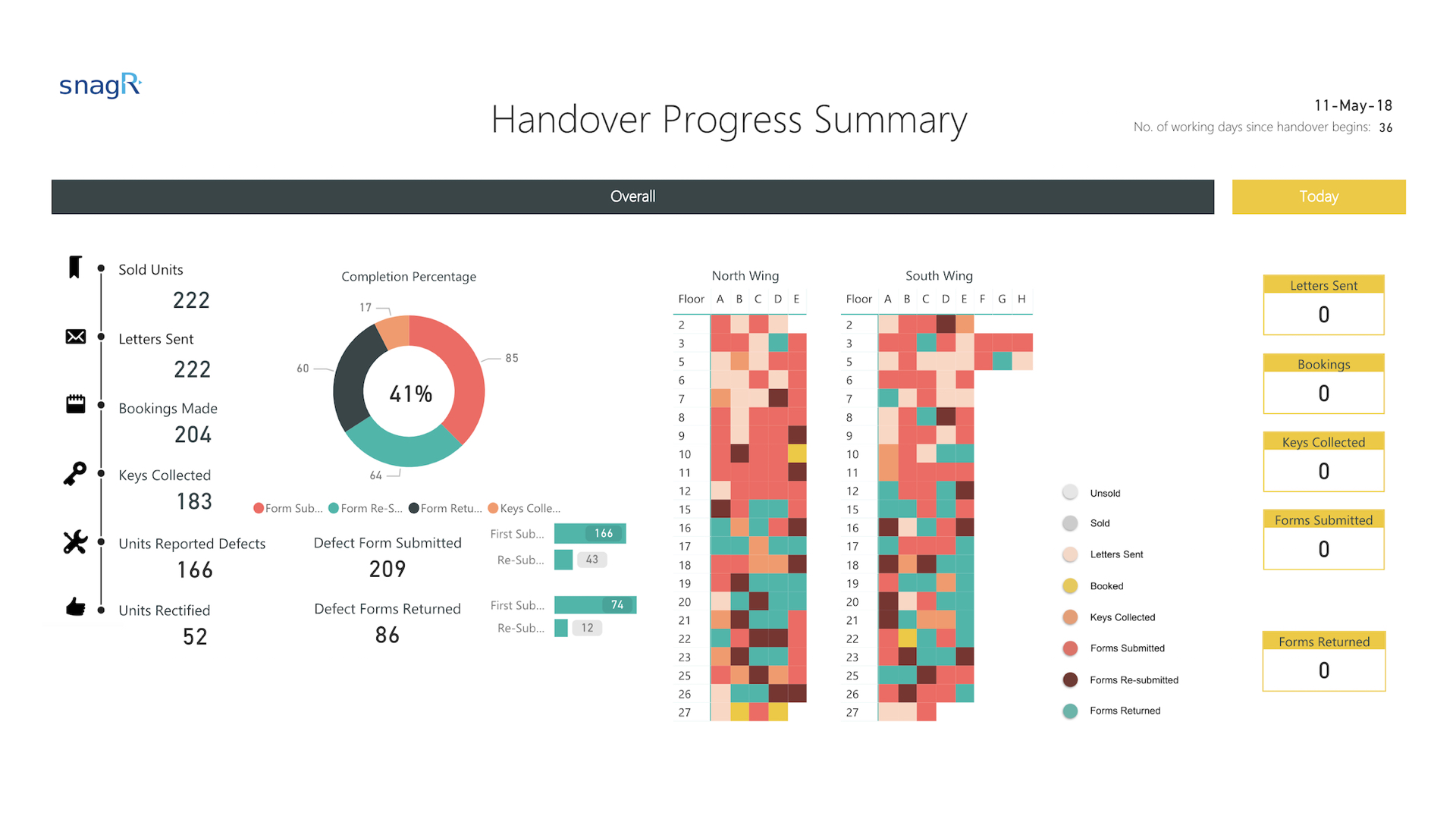

- Visualise progress and highlight outstanding items by due date

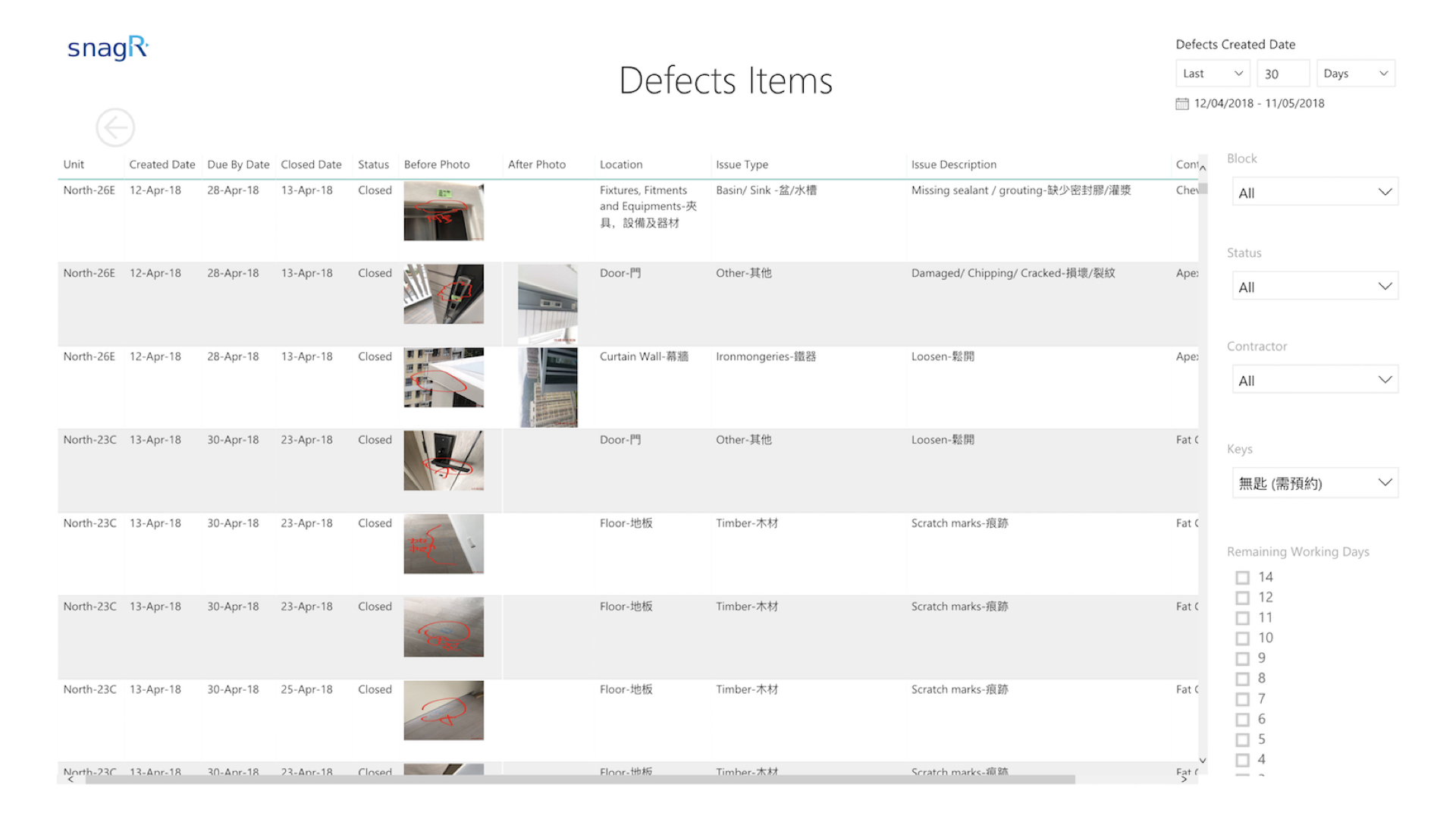

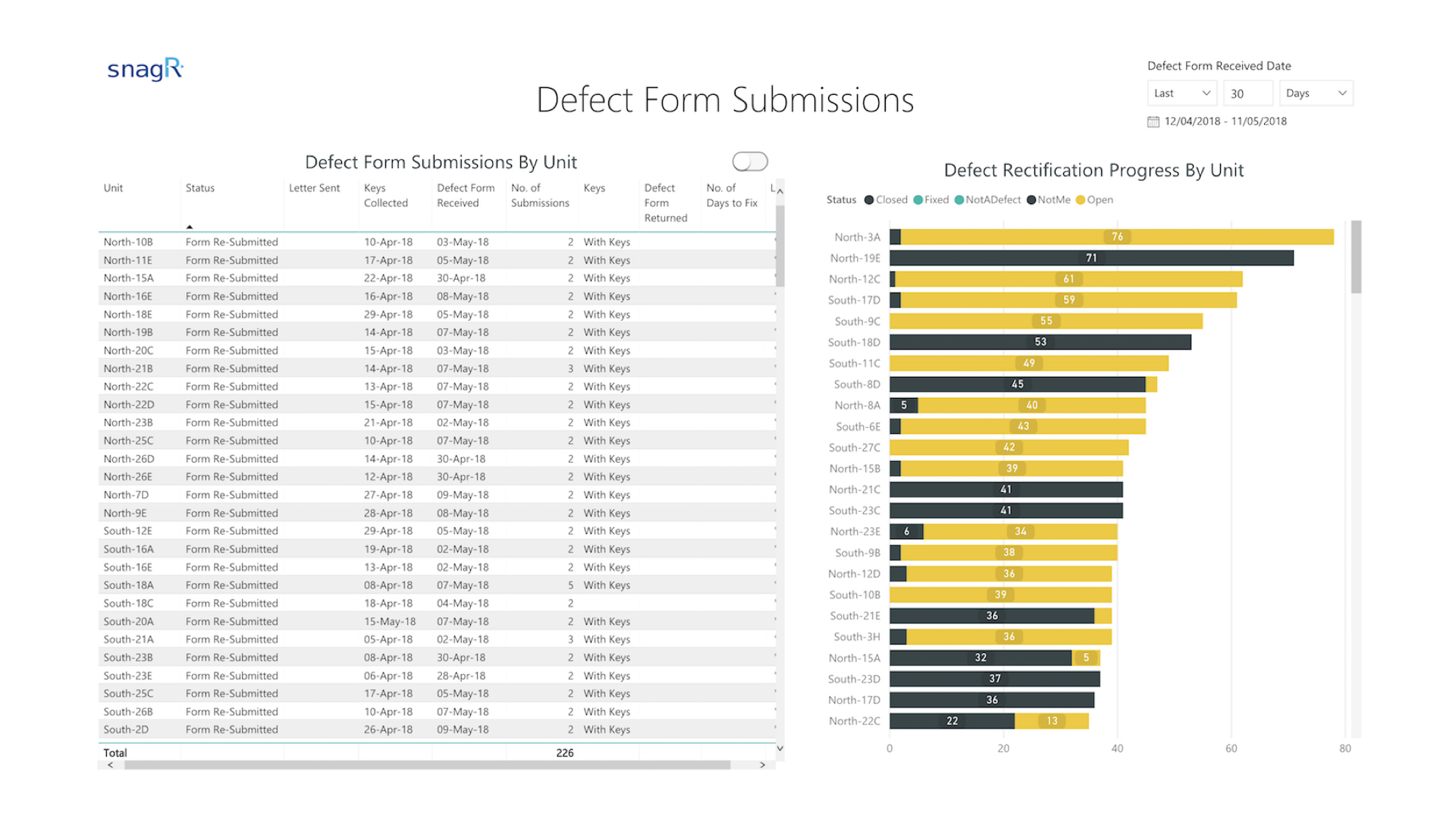

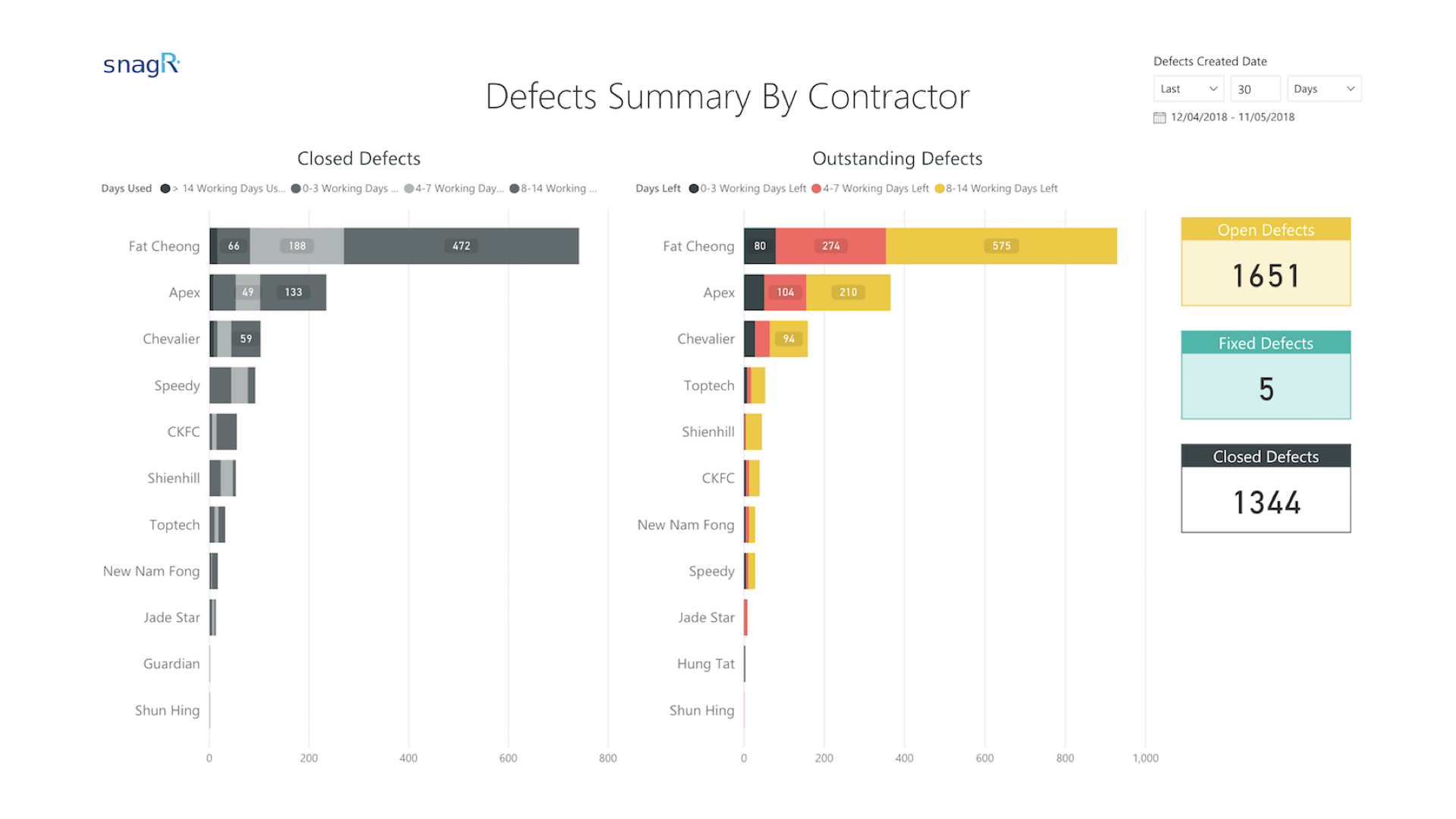

- Analyse defect types and subcontractor performance easily

- Layout plans per unit in PDF, png or jpeg (drawing title naming standard: [block]-[unit])
- List of users and contractors on the project
- List of standard issues / descriptions
- Which city is the project located? (to identify public holidays and calculate working days)
- Is the developer obliged to close defects within a certain number of working days by contractual terms?
- Does the property management office use Google Calendar to record appointment bookings with the purchasers?
